Building the Manifest

#

November

Final decoration is underway as well as new radiators in each of the toilets being connected to the existing heating system.

October

In the first week all internal studwork was erected and first fix electrics and plumbing.
Week two was plastering and internal door linings.
The toilets were then tiled and painted before fitting out with new and existing sanitaryware

September

The team completed the rear extension and then moved inside, a false floor was built to bring the floor level up to that of the stage.

The builders completed the shell of the front extension.

Friday 16th August

Team: Andy, John, Martin, Richard, Derek, Steve

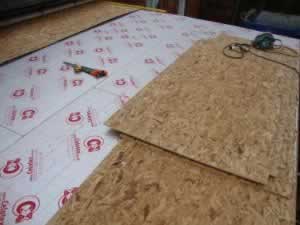

Richard and Martin lift all the sheets of boarding onto the roof - in the rain. Andy cuts and fits these, then 100mm of insulation, followed by more boarding. John, Derek and Steve clad the outside with weather boarding. Finally a tarpaulin is secured over the roof to keep the weather out until the roof is felted.

# #

#

Thursday 15th August

Team: Andy, John, Derek, Steve, Gordon

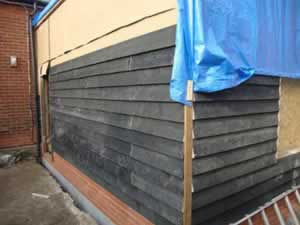

John, Derek and Bruce clad the exterior with boarding and then building paper to make the outside weather tight (still no roof!) Andy fitted the noggins between the rafters to create a rigid structure ready for boarding on Friday.
# # # # # # #

Wednesday 14th August

Team: Andy, John, Derek, Martin, Richard, Bruce, Gordon, Steve

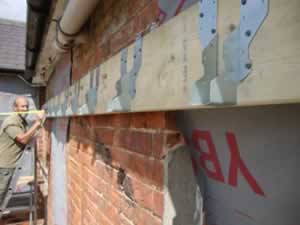

Derek and John remove the last window above the old door is removed and repair the sofit and facia in the corner of the theatre so the roof timbers can be fitted.
#
This photo shows the studwork required on a supporting wall, 3 times 6" x 2" bolted together at the sides of the door frame and across the lintel.


#
#

Tue 13th August

Team: Andy, John, Martin, Derek, Richard, Bruce, Gordon
Derek and John remove the old windows and build framework in the openings to support the new roof flashing. Found that the windows were well secured, one with 14 screws!

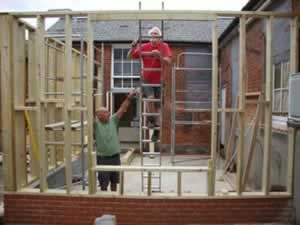

With Richard on the mitre saw and Martin on the nail gun, the stud walls for the extension are built in a day, the two door openings are left for final fitting out on Wednesday, but a quick check shows some minor adjustment is required for the double door. Derek directs from below.

#

Mon 12th August

Team: Andy, John, Martin, Derek, Richard, Bruce
Delivery from Travis Perkins arrives before lunch and thankfully the lorry manages to reverse as far as the railway bridge in Oxford Road. Several tons of timber are off loaded onto the road (where a line of cars usually park) then reloaded into trailers on Andy's and Richard's cars to take the final 100 yards to the theatre.

The remainder of the day is spent moving all the materials from the forecourt of the theatre to various locations ready for use. Find that we are 32 lengths of timber short that are needed to build the walls. TP manage to deliver later the same afternoon. Building to start on Tuesday. Jude pops in to take some work in progress photo's (hopefully to appear here later).

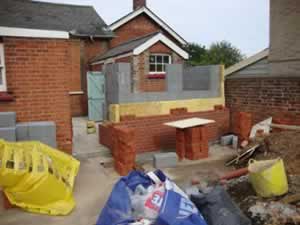

Wed 7th August

Team: John O'Connell
Footings for front extension dug and filled and start of brick walls.
#

Friday 26th July

Team: Andy Terry

Capped off old water supply to the various backstage feeds and renewed incoming stop tap in the storeroom.

#


This means that there is now only one stop tap for the building. If in future we need to replace the incoming supply from the water meter, we have only this one easily accessible tap to consider.
#

Thursday 25th July - AGM

Inspection of the building work for the rear extension. Brickwork completed and ready for the timber building. Floor requires concrete, insulation and screed.
#

Friday 12th July

Team: Andy Terry, John Terry, Jacquie Terry
Just a couple of hours in the afternoon, connected up toilet in what will be disabled toilet for Kerry and also the builders and team, Mum cleaned the auditorium from the worst of the dust, Dad removed the partition of the cast toilets.


Thursday 11th July

Team: Andy Terry, John Terry, Nigel Morton, Martin Rayner
Builders bought in digger to remove oversite for the front extension, the digging team had expressed an interest, but on second thoughts let the builders carry out this job. Very glad we did, as look at the concrete.
#
The Manifest team removed the backstage toilets, seeing as the drains were no longer connected. (they are in that pile of rubble somewhere!)

Wednesday 10th July

Team: Andy Terry, Steve Sadler
In the evening Steve and Andy removed the FOH toilets and demolished the wall between the Ladies and Gents toilets

Tuesday 9th July

Builders started today, Doorway knocked through tbetween foyer and disabled and channel for soil pipe between the new disabled topet to outside.
# #

Monday 8th July

Team: Andy Terry, John Terry, Nigel Morton, Martin Rayner
Sorry, but no photo's from today, just finished the digging of the footings and general clearing up.

Friday 5th July

Team: Andy Terry, Derek Butcher, John Terry, Martin Rayner
Breaking up of brickwork and concrete, Derek was the usual kango man, but was taking the picture this time.
#
John working hard as usual
#
Martin about to negotiate the ramp with a full barrow, notice the japenese headwear
#
Derek and Andy installing shuttering, as the side walls of the trench kept collapsing.
#
Finally, about 15 tons of soil in this heap, all removed and barrowed by the team
#


Thursday 4th July

Team: Andy Terry, Derek Butcher, John Terry, Martin Rayner, Bruce Emeny
Digging has started, Derek discovers an old step below the current playground.
#

The team survey their days work, this is the oversite being cleared, all soil is being barrowed through the theatre backstage.
#

June 2013

Work started this week by clearing the site for the rear extension,  the "garage" below used to be attached to the building as a stage wing, It will now be used as our furniture store.
#
The rear extension will provide a internal route for the cast to access the stage from this side, without having to resort to umbrellas!
#
The next stage is to dig the footings, which we are doing ourselves to keep costs down. The only access is through the backstage area of the theatre, so plenty of exersise for the "barrow" boys.
